Real Estate··9 min read

Investing in Kyiv New Builds at the Pit Stage in 2026: What Is Really Left After Delays, Fees and Tax

Buying an apartment in a Kyiv new build at the pit stage is the most profitable and the worst-calculated investment on the market. Profitable because the price per metre rises by a quarter to a third between launch and commissioning. Badly calculated because the developer shows the price rise while the investor forgets to subtract everything that stands between launch and cash in the account: the assignment fee, the tax, the commissioning delay and the months of registration.

Below is the full calculation on September 2026 terms.

Ruslan Averin — what a Kyiv new-build investor keeps of a 30% price rise after fee, tax and delay
Ruslan Averin — what a Kyiv new-build investor keeps of a 30% price rise after fee, tax and delay

The market the investor is entering

Kyiv's primary market rose 15.3% in hryvnia over the year, to UAH 63,300 per metre in August, about $1,410. Supply is shrinking: in January–July 2026 only 6 new residential complexes launched, against 10 in the same period of 2025 and 43 in 2021. The region saw 23 launches. Meanwhile demand for new builds dropped 21% in July month on month: buyers are waiting for autumn and for the NBU rate decision on 17 September.

The supply deficit is the main argument for entering: the fewer new projects, the dearer the finished ones. But the same deficit means there is little to choose from, and the cost of a wrong developer rises.

What is on offer at launch

Launch terms in September 2026, from the developers' own listings:

  • Rusanivska Havan (Kovalska): from UAH 49,445 per metre, 0% instalments with a 30% deposit until delivery, a 3% discount for paying half and 5% for paying in full;
  • Respublika (KAN): 0% instalments for up to 5 years with a deposit from 10%, assignment during construction prohibited;
  • Grand Bourget: 0% for 3 years with a 23% deposit, $1,050–1,150 per metre for full payment, price pegged to the dollar;
  • Svidomi: a 10% discount for full payment against 3% on a 5-year plan.

A launch price from UAH 49,445 against a city average of 63,300 is the stage discount: 22% below the market for finished housing of the same class. It closes as construction progresses.

The model: from a 30% rise to 17% in hand

Take a typical entry: a 45 m² apartment at $1,150 per metre, $51,750, paid in full at launch. The price of a finished apartment in the same building 30 months later is up 30%, $67,300. Gross profit: $15,550, 30% per cycle.

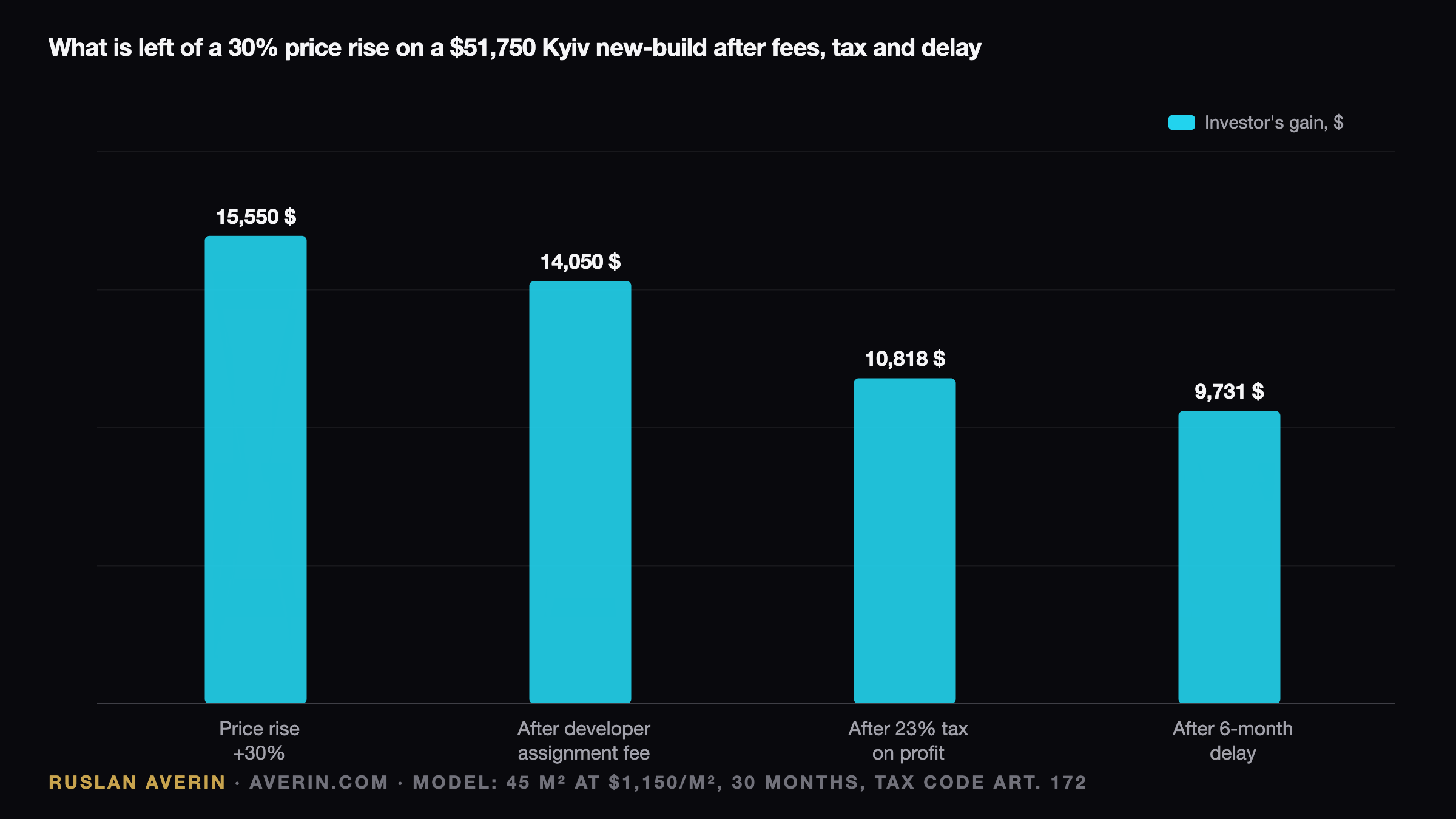

LineAmountRemaining
Price rise over 30 months+$15,550$15,550
Developer's assignment fee−$1,500$14,050
23% tax on profit (with cost deduction)−$3,232$10,818
6-month commissioning delay (forgone 4.2% a year)−$1,087$9,731
Net$9,731, 18.8% per cycle

Over a 36-month cycle including the delay that is 6.3% a year in dollars, above the net rental yield of a finished apartment (4.2%) but below what the "plus 30%" on the developer's slide promises. The gap between 30% and 18.8% is the cost of exit.

Selling not by assignment but after title registration, the tax becomes 10% of the full price, $6,730 instead of $3,232, and the result falls to 13.5% per cycle. That fork is covered in the piece on new-build sale tax.

What kills the return

Delay. Every six months beyond the deadline costs about 2% of return: the money does not work and the apartment is not let. In 2025–2026 Kyiv projects delivered three months to a year and a half late. Title registration after commissioning adds another two to eight months.

Freezes. In Kyiv region 111 of 908 residential complexes stand idle, 12.2%. In projects under Law 2518-IX the investor holds a special property right to a specific apartment, registered in the state register: it can be sold or pledged, and after commissioning it becomes ownership automatically. Under the old schemes, construction financing funds, forward contracts, derivatives, termination usually returns 50–70% of what was paid. Checking which scheme the developer sells under matters more than checking the floor plan.

Assignment bans. Some developers prohibit assignment before commissioning or before full payment. An investor in such a project has no exit until the building is delivered.

Overrated stage. A 20–25% stage discount exists only where the developer really sells below the market at launch. Projects with a dollar peg and full price at the pit deliver no "stage" gain, only the market's 5–15% a year.

How to choose

Three filters, in analyst Ruslan Averin's view, remove most of the risk:

  1. Sales scheme: only a special property right under Law 2518-IX registered in the state register; the developer's accreditation under eOselya (158 developers, 391 objects) is an additional sign of bank scrutiny.
  2. Delivery record: the same developer's previous phases delivered no more than six months late.
  3. Assignment right: written into the contract without a full-payment condition.

A project that passes all three returns 15–28% net per cycle. A project that fails the first is not worth even 40% of promised growth.

Related: four ways to invest in Kyiv, developer programmes, the fine print.

Frequently asked questions

How much does an apartment's price rise from pit to commissioning in Kyiv?
In projects of 2024–2026, by 25–40% in dollars over two to three years of construction. The upper bound is reached in comfort-class complexes near the metro, the lower in large projects where the developer keeps selling volume at launch prices until the end.
What tax does an investor pay on selling a new-build apartment?
On assignment of rights before commissioning: 18% PIT plus 5% military levy on the difference between the sale price and documented payments to the developer, 23% of the profit. After title registration: 10% of the full price if sold within three years of registration.
How protected is the investor if the developer halts construction?
In projects selling under Law 2518-IX the right to a specific apartment is registered before commissioning; it can be sold, pledged and used to demand completion. Under the old schemes, FFB, forwards, derivatives, termination usually returns 50–70% of what was paid. In Kyiv region 12% of complexes are frozen.
Which is better in 2026, a construction deposit or a finished apartment?
The construction deposit returns more: 15–28% net per cycle against 4.2% rent plus 5% annual price growth for a finished apartment. But construction pays no current income, has no liquidity before commissioning and carries delay risk, so no more than a third of capital should go there.

Ruslan Averin is an independent investor and market analyst, author of averin.com, publishing market research since 2014.
